Here are the catalogs from Lemon Tree, welcome to download them after leave your basic info.Hope our professional will helpful for yours.
Advantage: The outlook is more beautiful, the interior arrangement more flexible, the sound insulation and heat insulation with better performance due to modular T-house without visible column of (external) surface. It is a better choice to use for office of construction companies and display room.
Modular Prefab T House

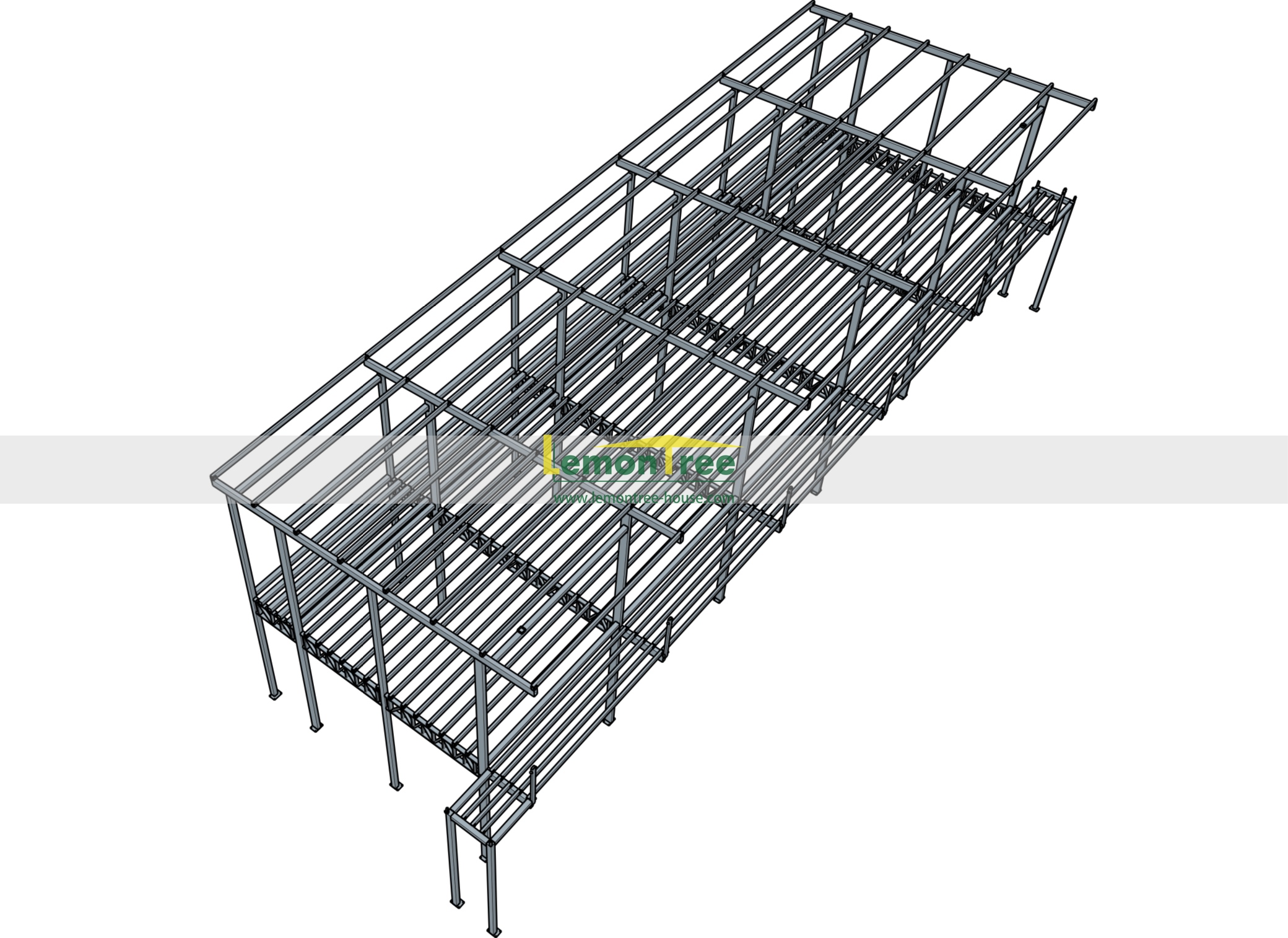

Following customer requirements to design, then all of T-house’ components are processed and finished at workshop, at last deliver them to site and set them up. It can shorten construction period and also can protect the working environment.

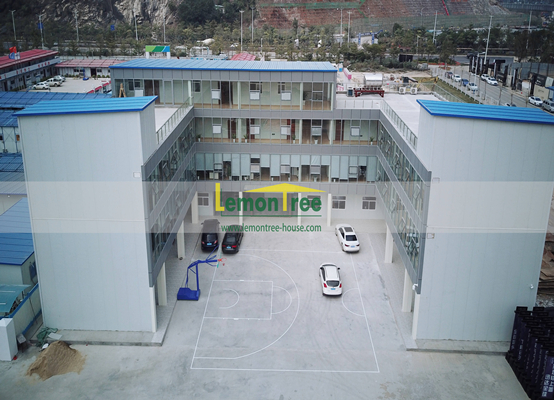

Application: It is widely applied to use as temporary house for engineering camps, government arrangement buildings, large-scale games and commercial events, etc.
Here is a basic material list for Prefabricated T-house for reference.

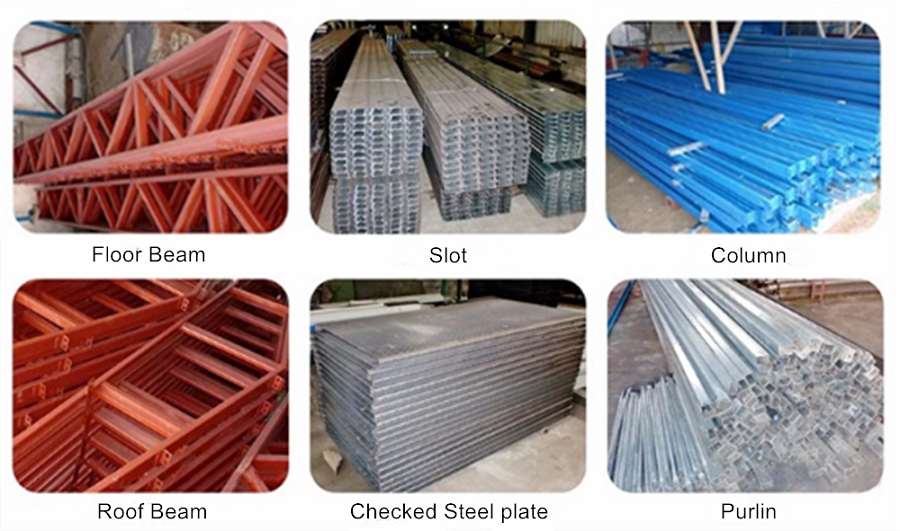

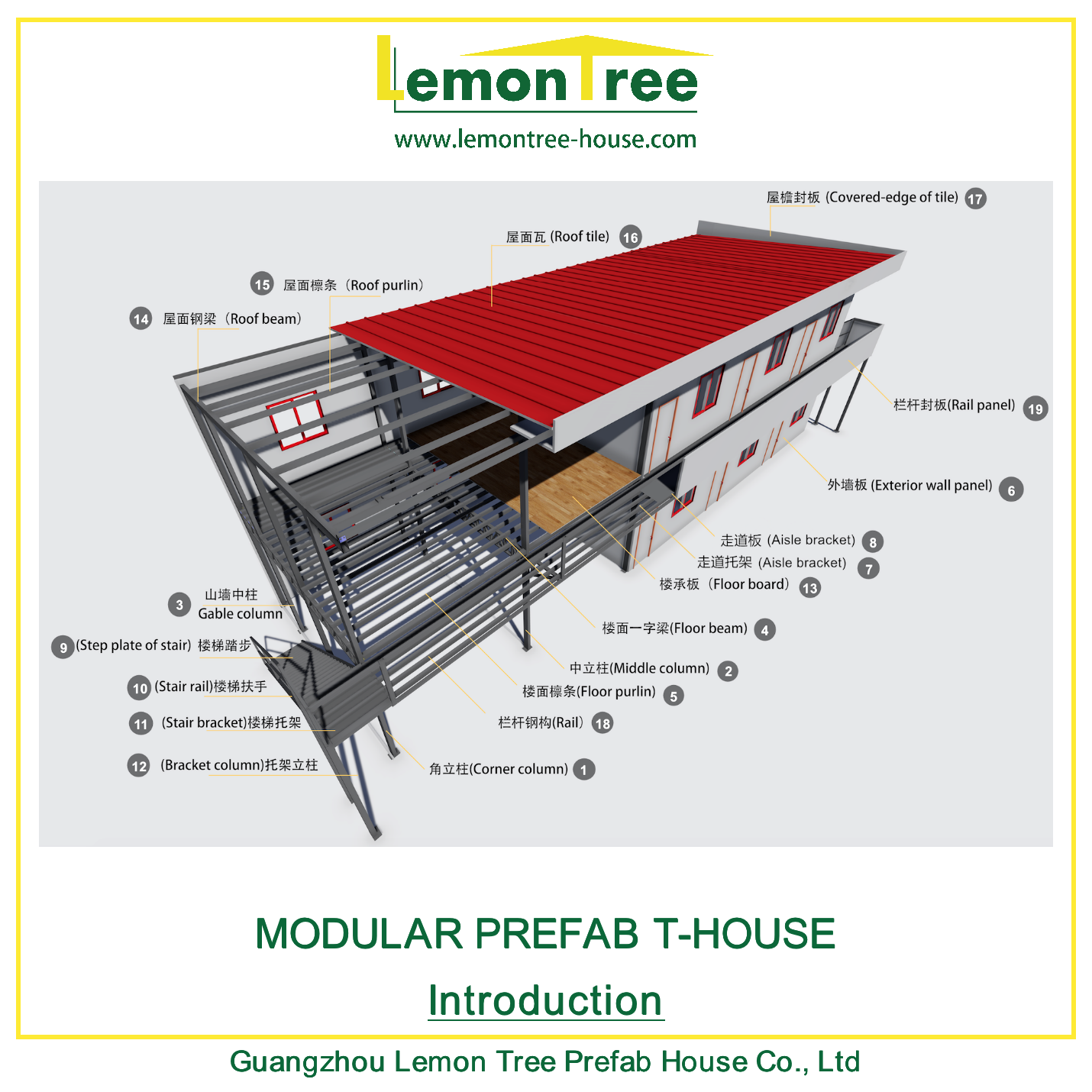

1)Stand column: □100x100x3.0;□100x150x3.0;□100x200x3.0
2)Roof beam: □100x150x3.0;□120x60x3.0;C80x2.0+C50x30x1.3
3)Floor beam: C80x2.0 + C50x30x2.0;□100x200x3.0
4)Ring beam: □100x100x3.0;□80x80x3.0
5)Horizontal support: L 50x3.0;
6)Floor purlin: C120x2.0;C100x2.0; Galvanized raw color.
7)Roof purlin: C80x2.0;C100x2.0;□80x40x2.0; Galvanized raw color.
8)Aisle board: Checked plate 2.3mm thk;
9)Staircase: C 160x2.5 & checked plate 2.3mm thk;
10)Glass wool sandwich wall panel: 50mm thk; density: 38kg/m³, steel plate thk 0.376mm;
11)Glass wool sandwich tile panel: 50mm thk; density: 35kg/m³, steel plate thk 0.376mm;
12)Partition slot: aluminum slot 1.0mm thk;
13)Hemming: thk 0.376mm blue color steel.

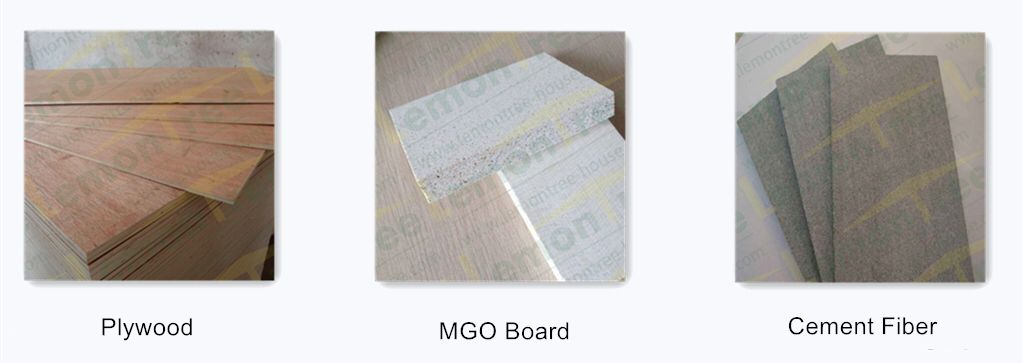

14)Floor board: thk 15~18mm plywood; (or thk 15-18mm cement fiber board )
15)PVC window & Sandwich door.

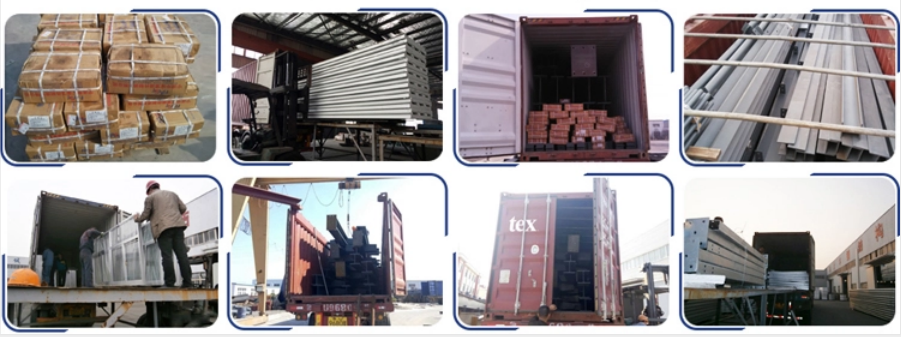

Due to all components of Modular prefab T house are separate, we would pack all the materials and put them in the counter as possible as we can. In general, One 40HQ shipment container can be loaded 200~300 square meters of materials. If you have any requirements about packing, you can communicate with us when ordering.

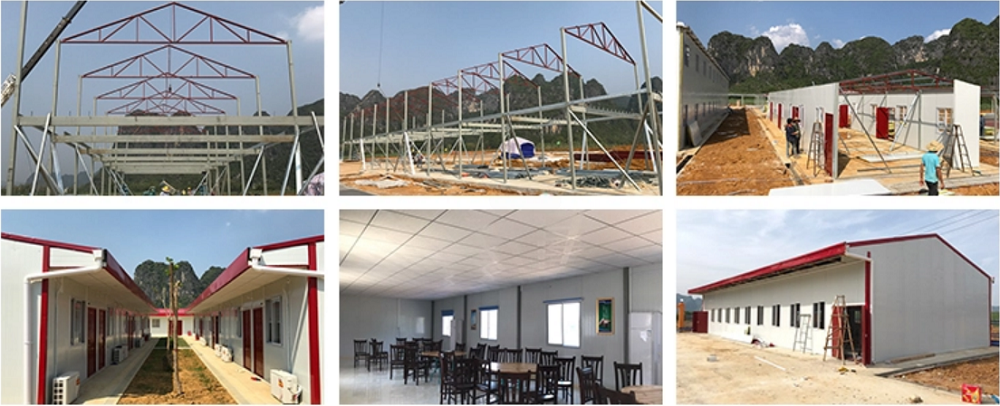

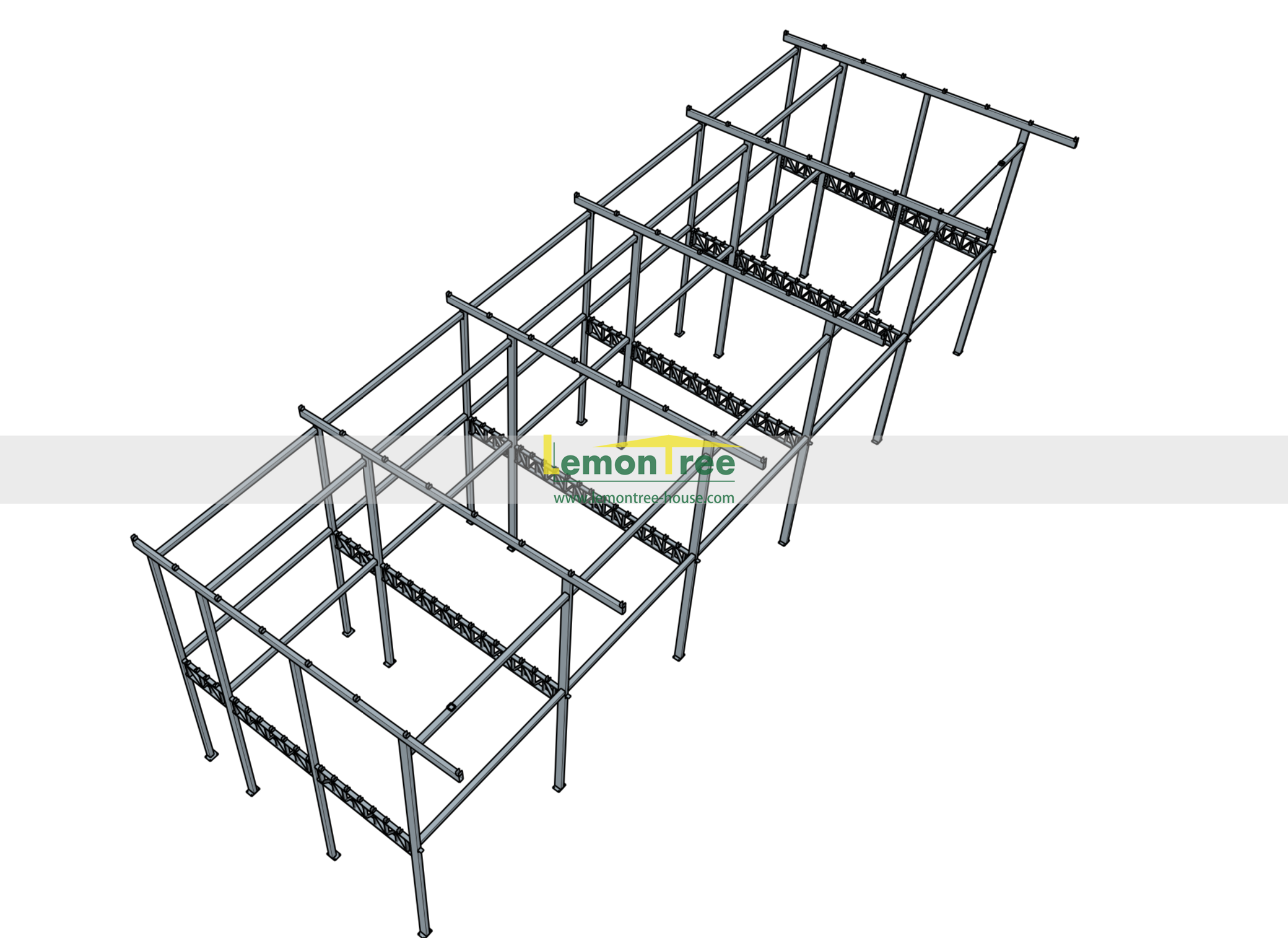

1)-Set the foundation as drawing, then start to erect the columns firstly.
2)-Install the ring beams to keep the structure stably.
3)- Set the floor beams & roof beams. (This kind of roof beams included the canopy structure)
4)-Assemble the stair brackets, then put on the floor purlins & the roof purlins.
5)-Assemble the staircase structure and set the aisle boards & the railing.

6)-Set the floor board and fix in the wall panels, at the same time fix the windows & doors.
7)-Fix the roof tiles, the covered-edges for the roof structure.
8)-Install sandwich panels for the railing of staircase & aisle. (Others installation, fixed the rivets and sealed the gaps by glass glue.)
